A Lifecycle Perspective: Why Bridge Management System Is Critical from Design to Decommissioning

A bridge management system (BMS) is software that keeps a record of every bridge in a network, forecasts how each one will deteriorate, and ranks repair, rehabilitation and replacement work by cost, risk and condition. Agencies use it to decide which bridges need work, what treatment fits, and when to act, from design through decommissioning. A BMS also produces the condition and performance reporting that federal rules require.

Updated November 9, 2026

Bridge lifecycle overview

Bridges connect families, communities and freight corridors. Caring for them over decades, across several agencies, tight budgets and changing regulations, takes consistent data and clear priorities. That is the job of a bridge management system.

What is a bridge management system?

A bridge management system is a decision-support tool for bridge owners. It stores inventory and inspection data, models how components deteriorate, estimates the cost and benefit of each treatment, and recommends a program of work that fits the agency's budget and performance targets. Agencies sometimes call it BMS software or a bridge asset management system. The idea is the same: move from fixing the worst bridge first to planning the right work at the right time.

How does a bridge management system support the whole bridge lifecycle?

Every bridge goes through planning and design, construction, operation and maintenance, rehabilitation or upgrade, and finally decommissioning or replacement. Managing each phase in isolation tends to produce reactive decisions and rising costs. A lifecycle approach lets agencies plan ahead and spend where it counts.

The five phases of a bridge's life

Lifecycle costs a BMS tracks

  • Initial costs: design, construction and land acquisition.
  • Operations and maintenance costs: inspections, repairs and systems.
  • User costs: costs to the public from work zones or closures, including traffic delay, vehicle operating and accident costs.
  • Environmental and social costs.
  • End-of-life costs: disposal, replacement and remediation.

What does bridge management software do?

A BMS goes beyond data storage. It gives bridge inspectors and managers four core capabilities.

Bridge management system concept

How can agencies track bridge inventory and inspection workflows?

A BMS holds a central, current record of every bridge's location, type, age and condition. That supports timely inspections and reporting, and shows system-wide health at any moment. Field capture tools such as inspectX™ feed that record directly from the inspection.

How do agencies prioritize maintenance, repair and rehabilitation?

A BMS builds on inventory and inspection data to forecast deterioration, then compares treatment options and costs. This moves the agency from simple data management to predictive forecasting and financial optimization.

How can agencies control lifecycle costs and budget more effectively?

BMS tools support Lifecycle Cost Analysis (LCCA), so planners can compare the long-term cost of each intervention and balance short-term needs against long-term asset value. A BMS also quantifies user costs, so projects that minimize public disruption rank higher.

How can agencies monitor performance and optimize operations?

Performance metrics and optimization algorithms predict outcomes, compare strategies and recommend the most efficient path for safety, reliability and return on investment.

Bridge management system core functions

What is the cost of not having a bridge management system?

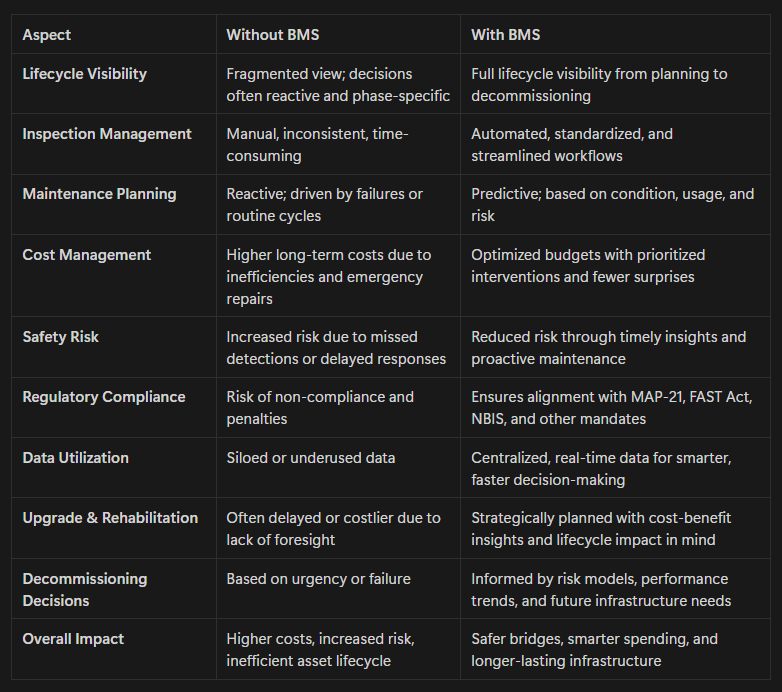

[NEEDS INPUT: this section was image-only in the original. A human needs to transcribe the text in the graphic below, or supply the points to state, so it can be written as page text.]

Text graphic comparing bridge programs without and with a bridge management system

How does a bridge management system measure and optimize performance?

A BMS turns inspection data into measurable outcomes using performance metrics and optimization models. This helps agencies prioritize actions and maximize asset value across the network.

Performance measures and optimization in a bridge management system

What performance indicators does a BMS report?

Share of bridge elements in good or poor condition. This measures the proportion of components, such as deck, superstructure and substructure, rated Good or Poor under inspection standards. Federal rules attach consequences to it: under 23 CFR 490.413, if more than 10 percent of a state's National Highway System (NHS) bridge deck area is on structurally deficient bridges over a three-year period, the state DOT must set aside funds for NHS bridge projects. [NEEDS INPUT: confirm whether to quote the current "Poor" definition (rating of 4 or less) from 23 CFR 490.409, which was not checked in this run.]

Safety and risk-based vulnerability indices. These score a bridge on structural health, age, traffic, load limits and exposure to hazards such as floods and earthquakes. Caltrans, for example, uses seismic risk ratings for bridges in quake-prone areas. [NEEDS INPUT: the original attributes risk-based scoring to FHWA requirements under MAP-21 and the FAST Act; cite the specific rule or remove.]

What are the components of a BMS optimization framework?

1. Deterioration forecasting

Markov models use a Transition Probability Matrix (TPM), built from historical inspection data, to estimate the chance that a component moves between condition states, for example Good to Fair, in a given year. Advanced versions add factors such as climate and traffic. For more on the methods, see our guide to modeling bridge deterioration.

2. Treatment modeling

A treatment model captures the type of maintenance or rehabilitation action, its cost, the condition improvement it delivers and its effect on long-term deterioration. Grounded in lifecycle cost analysis, it also embeds practical rules such as condition thresholds, deterioration trends and component-specific triggers, to recommend the most cost-effective timing and type of intervention.

3. Multi-objective analysis

These frameworks optimize several goals at once, for example maximizing average network condition while minimizing risk, lifecycle cost and the number of structures in Poor condition. An advanced BMS offers several analysis types: optimizing network performance under financial and operational constraints, or finding the minimum budget needed to reach target goals. These support short- and long-term capital planning and project prioritization.

4. Budget and performance constraints

A scalable BMS handles several user-defined constraints at once, such as a fixed annual budget, caps by work type (preservation, rehabilitation, replacement) and condition or risk thresholds. An agency subject to the 10 percent NHS deck-area limit above can build that limit into the analysis so the program stays compliant while network performance is maximized.

5. Optimal lifecycle planning

An advanced BMS optimizes lifecycle cost at both structure and network level, finding the treatment strategy with the lowest lifecycle cost that still meets safety, budget and performance constraints. At network level, Integer Linear Programming (ILP) and Incremental Benefit-Cost Ratio (IBCR) are the most common techniques. NCHRP Report 590 compared the two in bridge management planning.

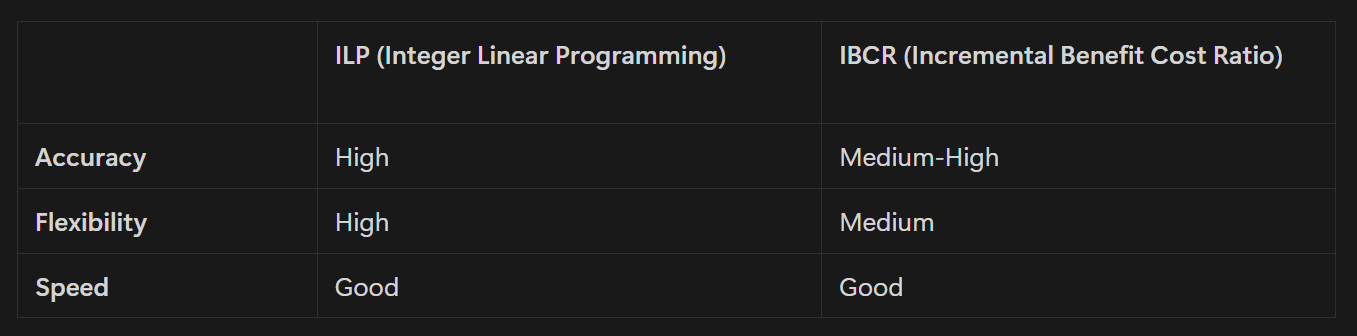

How do ILP and IBCR compare?

Based on NCHRP Report 590 and AssetIntel™'s technical assessment.

Comparison of ILP and IBCR optimization techniques

What results have agencies seen from bridge management systems?

A 2012 FHWA study, Bridge Management Practices in Idaho, Michigan, and Virginia, described how three state DOTs used bridge management to move from reactive fixes to proactive care.

  • Idaho: from 2006 to 2011, the share of State-owned bridge and culvert deck area in good condition rose from 67 percent to 74 percent.
  • Michigan: the number of structurally deficient bridges fell by more than half after the state moved from a worst-first approach to a balanced, data-driven strategy.
  • Virginia: the statewide goal is no more than 8 percent of bridges and culverts structurally deficient; the total was 8.2 percent in 2011.

What is next for bridge management systems?

BMS platforms are adding AI, IoT and digital modeling for real-time visibility, deeper diagnostics and lifecycle strategy.

Real-time sensing and situational awareness

  • Sensor-based monitoring: track load, stress and vibration in real time.
  • Remote sensing and satellite data: detect structural shifts early with aerial and thermal imagery.
  • Climate risk tools: assess exposure to floods, seismic zones and extreme weather.

Predictive intelligence and diagnostics

  • Non-destructive evaluation (NDE): ultrasonic, infrared and magnetic tools detect hidden defects.
  • Predictive maintenance: analyze condition trends to forecast deterioration and plan interventions.
  • Machine learning models: identify risk patterns across materials, traffic loads and environmental stressors.

Digital ecosystems and lifecycle strategy

  • Bridge Information Modeling (BrIM): 3D models to visualize conditions and plan upgrades.
  • Digital twins: merge BrIM with sensor data for real-time simulation, monitoring and what-if planning.
  • Enterprise interoperability: sync the BMS with financial systems, asset platforms and capital plans.
  • Carbon tracking and sustainability metrics: inform material choices and greener lifecycles.
  • Equity and resilience standards: direct investment toward accessibility and underserved communities.

How does manageX™ compare with traditional bridge management systems?

manageX™ builds on proven BMS practices with significant enhancements. Its optimizer is based on Integer Linear Programming and weighs structural safety, agency requirements and risk-based planning for short- and long-term decisions. It is cloud-hosted, with enterprise-grade security, rapid deployment, built-in deterioration modeling and transparent optimization tools. Learn more about manageX bridge management software.

manageX platform overview

Design and planning

A BMS evaluates design alternatives using lifecycle cost and performance data, supporting value engineering, durable material choices and early climate and risk analysis. During construction it tracks activity against lifecycle cost models. With BrIM workflows, the final as-built 3D model can be ingested into the BMS as a permanent, data-rich record for later inspection, maintenance and analysis.

Operations and maintenance

A BMS automates inspection scheduling, tracks condition trends and integrates sensor and NDE data. That integration is the core of a bridge digital twin: a living virtual model that supports real-time health monitoring and predictive, reliability-centered maintenance.

Rehabilitation and upgrades

Using deterioration models, inspectors can identify cost-effective maintenance, repair and rehabilitation strategies and evaluate return on investment. The BMS then optimizes budget across network-level priorities, such as a five-year capital plan, and project-level priorities, such as the best repair strategy for one bridge.

Decommissioning and replacement

A BMS helps forecast remaining service life, plan for the environmental and financial effects of decommissioning, and use historical data to inform future decisions.

What is the history of bridge management systems?

[NEEDS INPUT: the original states that modern BMS date to the late 1980s, that the 1991 ISTEA required states to implement them, and that later tools built on FHWA's legacy Pontis software. None of this could be confirmed from FHWA's current bridge management page in this run, and the 2012 FHWA article says only that Pontis is available through AASHTOWare. Provide a source or approve removal.]

Frequently asked questions

What is a bridge management system?

A bridge management system is software that stores bridge inventory and inspection data, forecasts deterioration, and ranks maintenance, repair and replacement work by cost, risk and condition.

What is bridge management software used for?

Agencies use it to plan inspections, forecast condition, compare treatment options, set budgets and report performance across a bridge network.

What is the difference between a bridge management system and bridge asset management?

The terms overlap. A bridge management system is the tool; bridge asset management is the wider practice of managing bridges as assets across their lifecycle, which the BMS supports with data and analysis.

Conclusion

With aging infrastructure and limited budgets, agencies cannot rely on short-term fixes. A modern BMS shows which bridges need attention, when and why, so resources go where they matter most.

Bridge lifecycle intelligence summary

To see how a bridge program can benefit from lifecycle intelligence, schedule a call.
